How to Plan, Track, and Deliver IT Projects in TaskFord

Learn how to plan, track, and deliver IT projects in TaskFord. Organize phases, assign work, manage dependencies, and monitor progress from start to finish.

9 minutes read
Share:

IT projects involve a lot of moving parts — multiple teams, shifting priorities, technical dependencies, and stakeholders who need updates without being pulled into every detail. Without a clear system, work gets scattered across tools, blockers go unnoticed, and deadlines slip.

TaskFord gives you one place to plan, execute, and track IT project delivery from start to finish, so your team always knows what’s happening and what needs attention.

This guide walks you through how to use TaskFord to manage a cloud migration end-to-end, from setting up the project structure and assigning work, all the way to monitoring progress and reporting outcomes to stakeholders.

You don’t need to set everything up perfectly from the start. Follow these steps and your project will quickly take shape.

What you’ll build:

By the end of this guide, you’ll have:

  1. A structured IT project with phases, milestones, and a clear delivery timeline
  2. Tasks broken down, assigned, and linked with dependencies
  3. Full visibility into progress, blockers, risks, and team workload
  4. A status dashboard your stakeholders can follow without asking for updates
  5. A clean project closure with actuals documented for future planning

What is IT Project Management?

IT project management is how teams plan, coordinate, and deliver technology initiatives such as cloud migrations, software deployments, infrastructure upgrades, and system implementations.

It helps answer four key questions:

  • What needs to be delivered?
  • Who owns the work?
  • What risks or dependencies could affect delivery?
  • Are we on track?

TaskFord brings the plan, tasks, owners, timelines, and progress into one place. Work rolls up from subtasks to tasks, tasks to milestones, and milestones to the project, giving your team a clear view of delivery without rebuilding status reports manually.

Before you start: Set up your IT project

There are two quick ways to get started:

  • Use the Project Management template in TaskFord. It comes pre-configured with phases, milestones, and a task structure so you’re not building from scratch on day one.
  • If you already have a project plan in a spreadsheet, use TaskFord’s CSV importer to bring your existing tasks in and build from there.

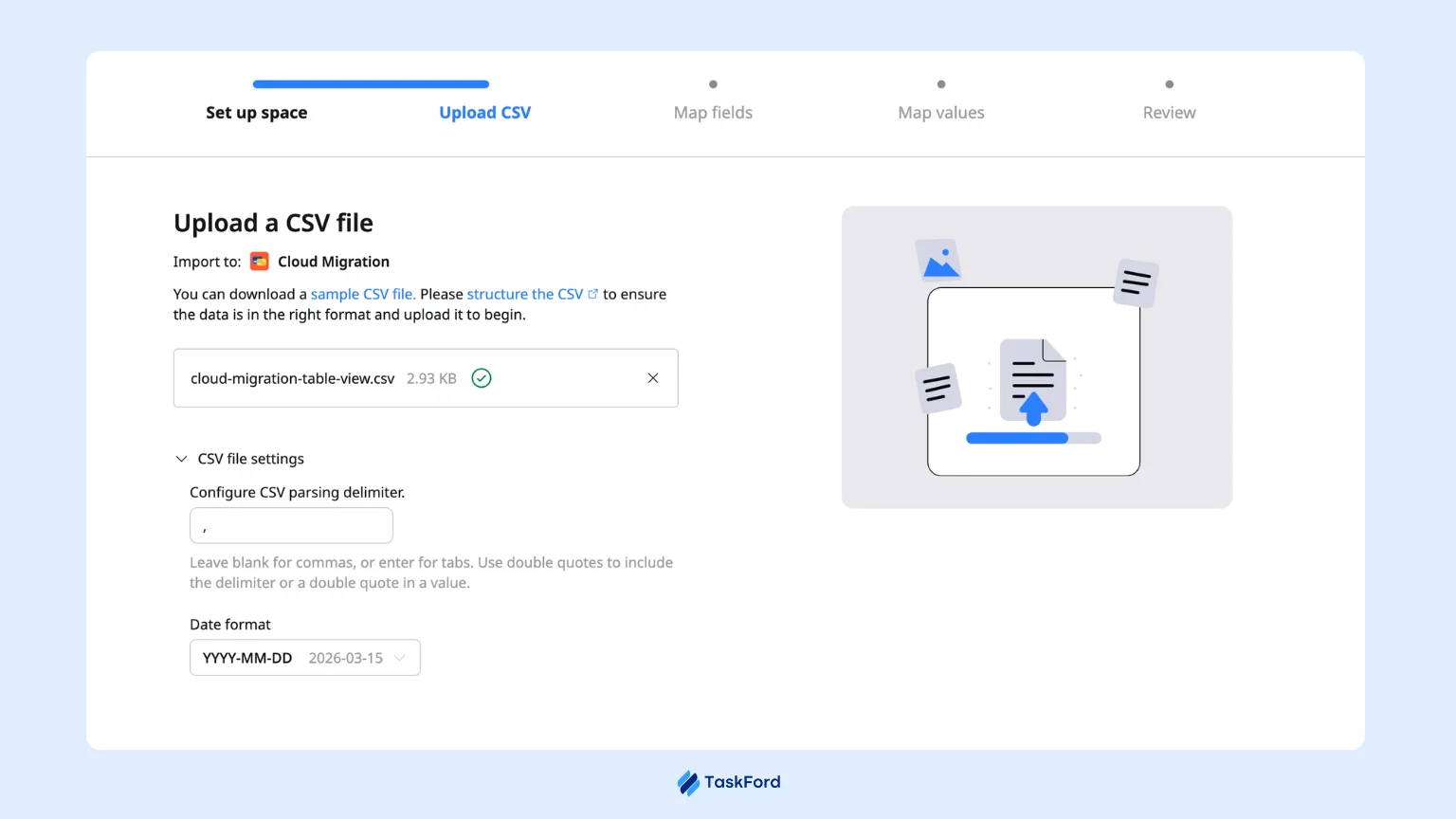

TaskFord’s CSV importer

If your migration involves multiple workstreams. For example, infrastructure, security, and application teams, consider creating a separate project per workstream. This keeps scope focused and progress easier to track.

Step 1 – Define your project structure

Before any work starts, you need the full project structure in place. A clear structure makes sure everyone knows what phase they’re in, what’s expected, and what comes next.

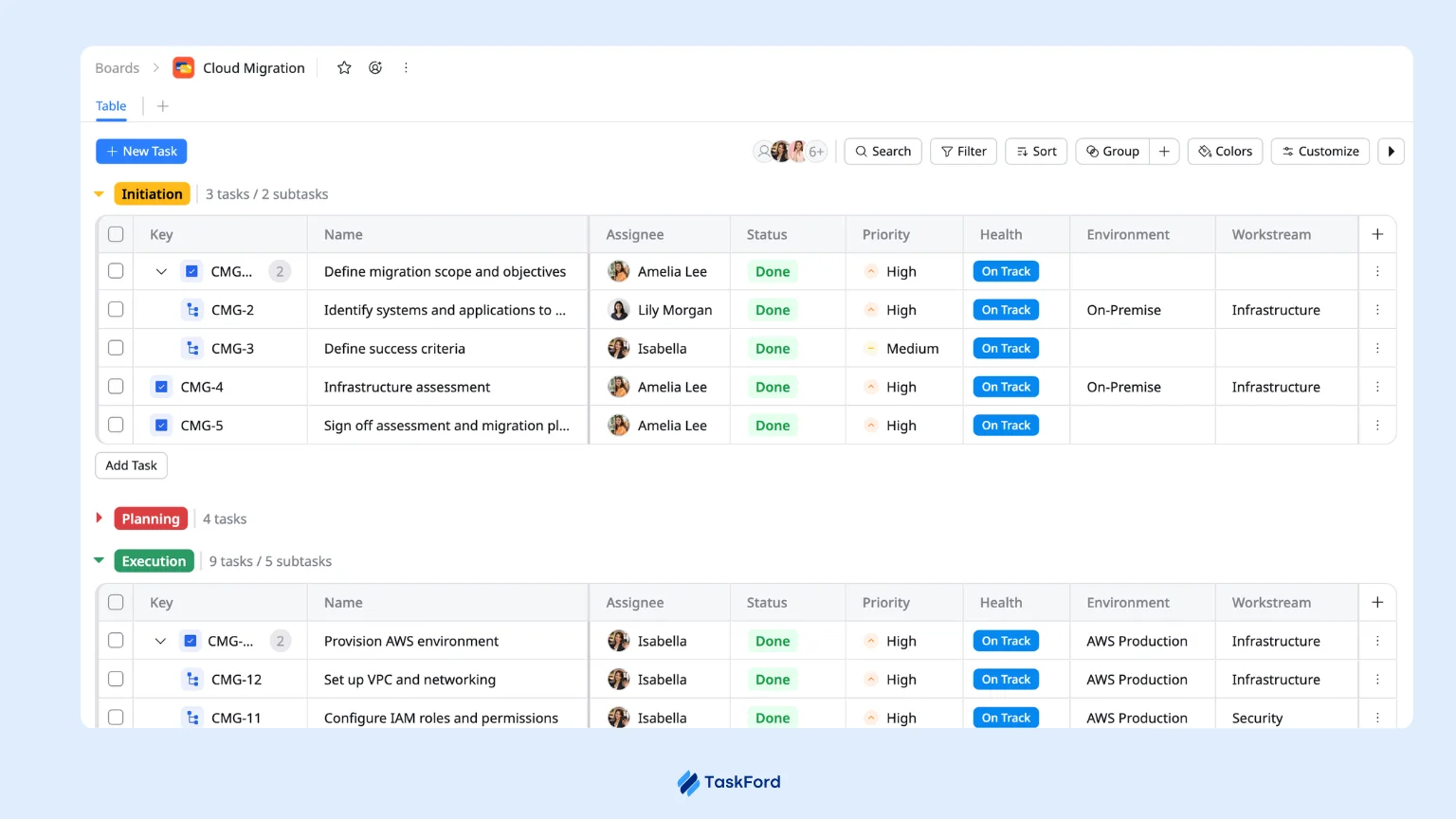

define it project delivery in taskford

To set up your project:

  1. Create a new project in TaskFord, for example, “Cloud Migration — On-Premise to AWS” and set the start and end date.
  2. Add sections to represent your delivery phases: INITIATION → PLANNING → EXECUTION → CLOSURE
  3. Set milestones for key checkpoints such as infrastructure assessment sign-off, cloud environment ready, data migration complete, UAT sign-off, and go-live approved.
  4. Add custom fields to capture the details that matter on every task:
Custom Field Options
Environment On-Premise / Staging / AWS Production
Workstream Infrastructure / Security / Application / Data
Health On Track / At Risk / Off Track

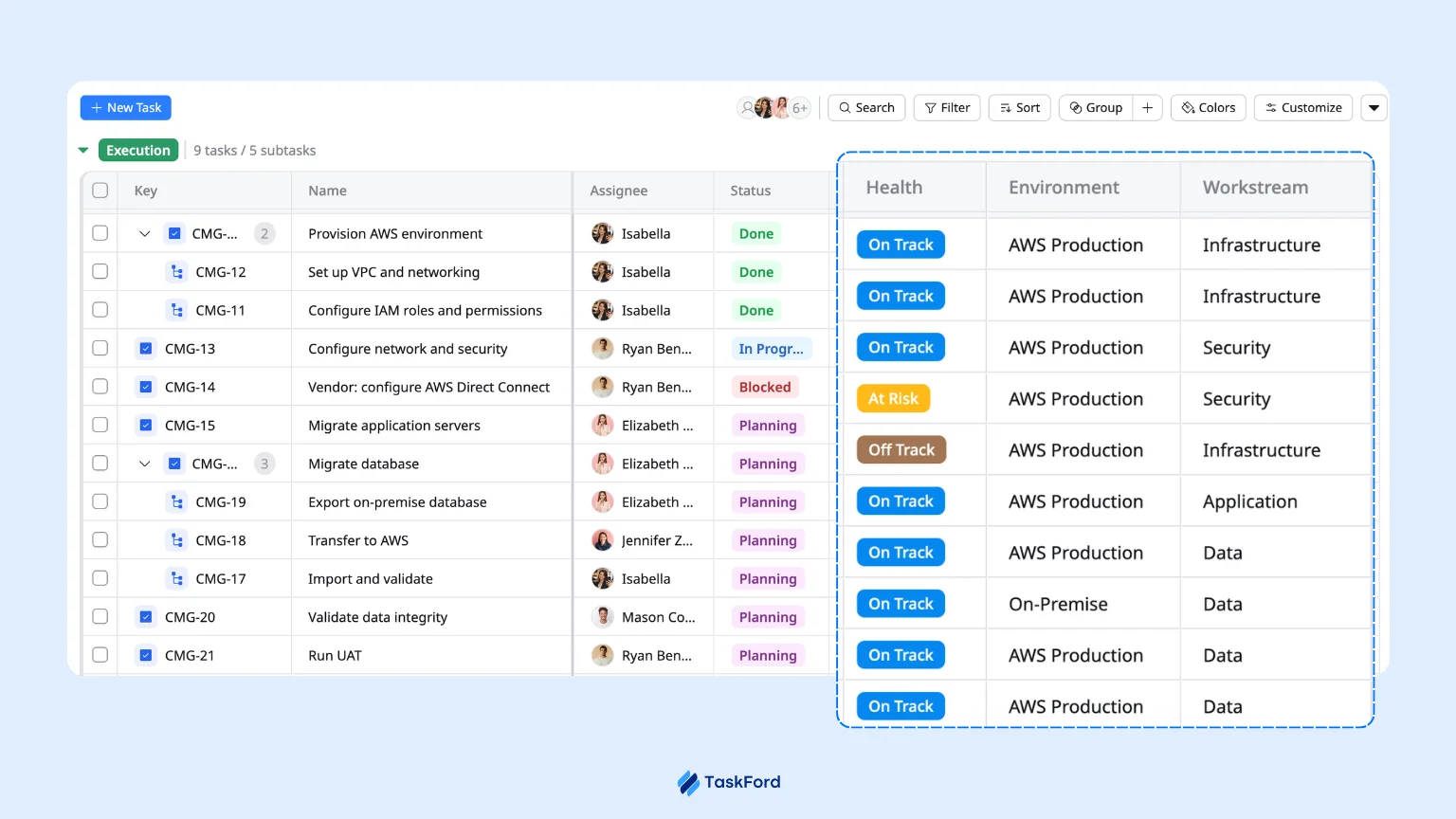

create custom fields in IT project delivery taskford

💡 Tip: Add a Health field to every task. It lets you filter everything that’s Off Track in one click — without reading through every task one by one.

Step 2 – Break down work and set dependencies

A project plan only works when the work is broken down clearly enough for people to act on immediately.

To build your task structure:

  1. Under each phase, create tasks for every piece of work. For example, under Execution: Provision AWS environment → Configure network and security → Migrate application servers → Migrate database
  2. Break complex tasks into subtasks and assign each one separately — for example, Migrate database breaks into Export on-premise database → Transfer to AWS → Import and validate

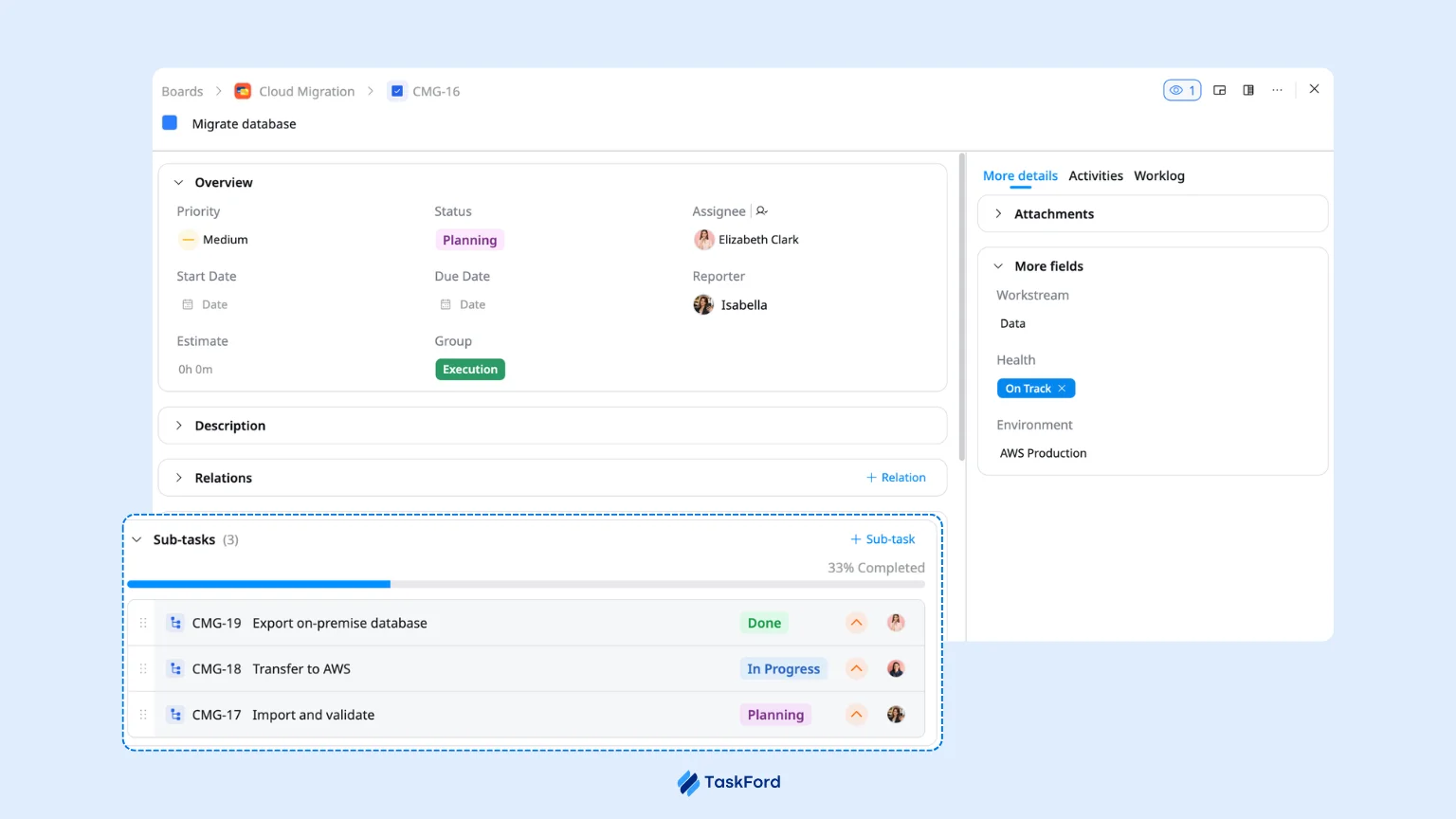

break down by subtasks

  1. Never assign a parent task to multiple people, shared ownership means no one owns it
  2. Set task dependencies so the team knows what can’t start until something else is finished
  3. Assign an owner and due date to every task before the project starts, unassigned tasks always get dropped

Common dependency patterns in this migration:

Dependency Example
Setup before configuration Provision AWS environment → Configure network and security
Configuration before migration Configure network and security → Migrate application servers
Application before database Migrate application servers → Migrate database
Migration before validation Migrate database → Validate data integrity
Vendor delivery before testing Vendor: configure AWS Direct Connect → Run UAT
Validation before testing Validate data integrity → Run UAT
Testing before cutover UAT sign-off → Cut over to production

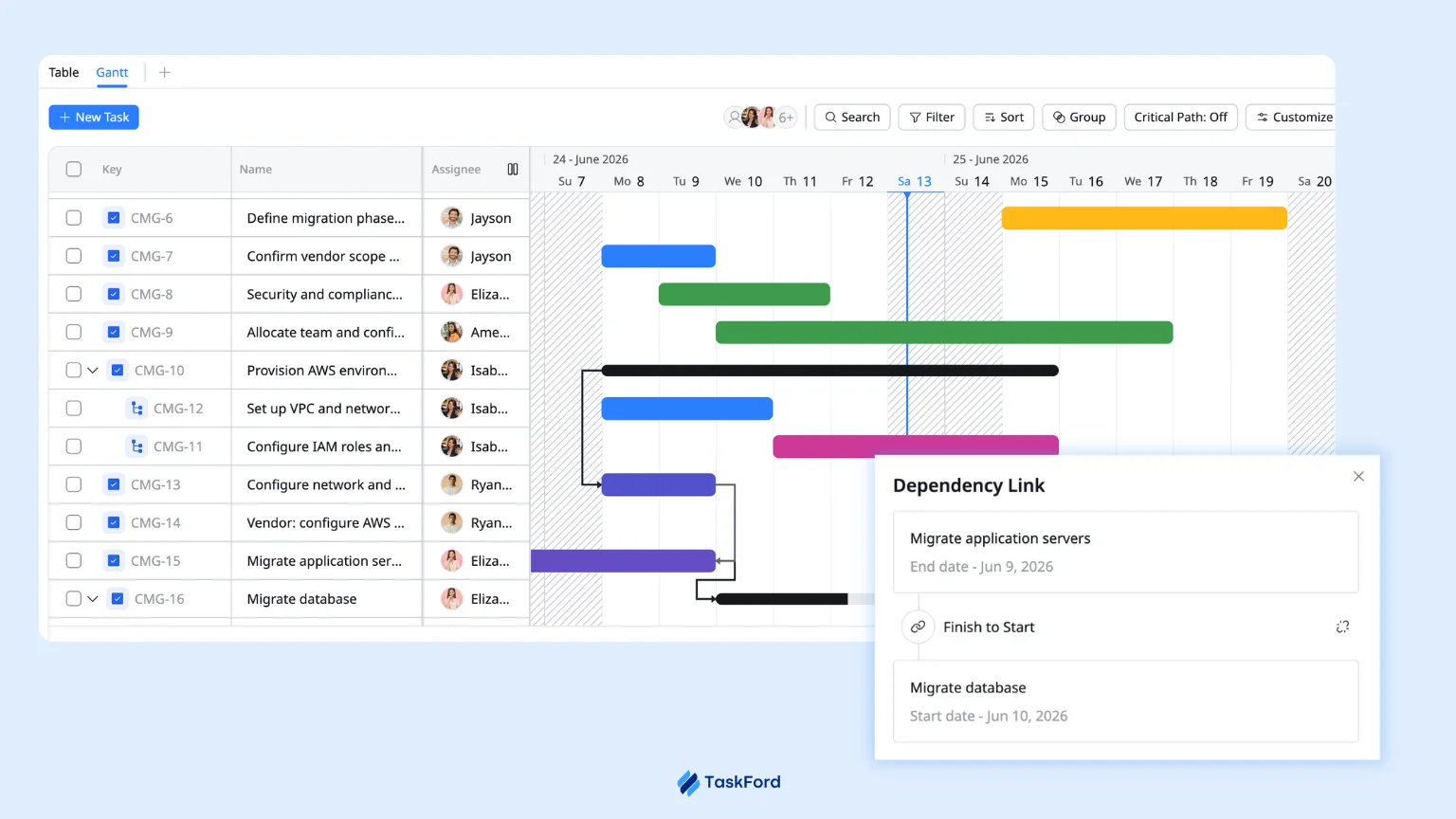

task dependencies for IT project management

💡 Tip: In Gantt view, dependencies render as connecting lines between tasks. When one task slips, you’ll see every downstream task and milestone that moves with it — before it’s too late to act.

Step 3 – Coordinate teams, vendors, and stakeholders

A cloud migration involves more than just one team. You’re coordinating the infrastructure team, security team, application owners, and an external cloud vendor – all working on different parts of the same delivery.

To manage coordination in TaskFord:

  1. Assign tasks to the right people and check their current workload before committing them. Open Workload View to see who’s available, who’s already at capacity, and whether critical engineers are overloaded before it impacts delivery timelines. workload view
  2. Use @mentions in task comments to loop in the right person when a decision is needed, for example, @mention the Security Lead when firewall configuration needs sign-off. The thread stays on the task so nothing gets lost in email
  3. Attach relevant documents – SOWs, network diagrams, security policies, UAT sign-off forms, directly to the task so everyone works from the same version

💡 Tip: Filter tasks by Assignee to see everything assigned to the vendor in one view. If their AWS Direct Connect task is Blocked, you’ll know immediately what’s at risk downstream.

Step 4 – Manage scope changes without losing control

Scope changes are inevitable. The security team requires additional compliance controls mid-execution. A business unit requests an extra application to be migrated. The vendor delivers a configuration that doesn’t match the original spec.

The risk isn’t the change itself, it’s losing track of the original plan when changes aren’t logged properly.

To manage scope changes in TaskFord:

  1. Never modify an existing task to absorb a new request, create a new task so the original scope stays intact
  2. Add the new task to the relevant phase and check Gantt view to see what moves before committing to a timeline
  3. Document what changed, who requested it, and why it was approved in the task comment thread
  4. If the change affects go-live, update the milestone so stakeholders see it on the dashboard immediately

Read also: 5 Must-Know Project Scope Control Strategies

💡 Tip: Tag scope change tasks with a Scope Change label. Filter by it anytime to see exactly what was added after the project started – useful for post-project reviews.

Step 5 – Monitor progress and catch problems early

Four weeks in, cutover is three weeks away. You need to know what’s on track and what’s slipping, before it’s too late to act.

Use the right view for the right question:

  • Gantt view – answers “Will we hit go-live?” When the Migrate database tasks slip, you’ll see UAT and cutover move before it happens

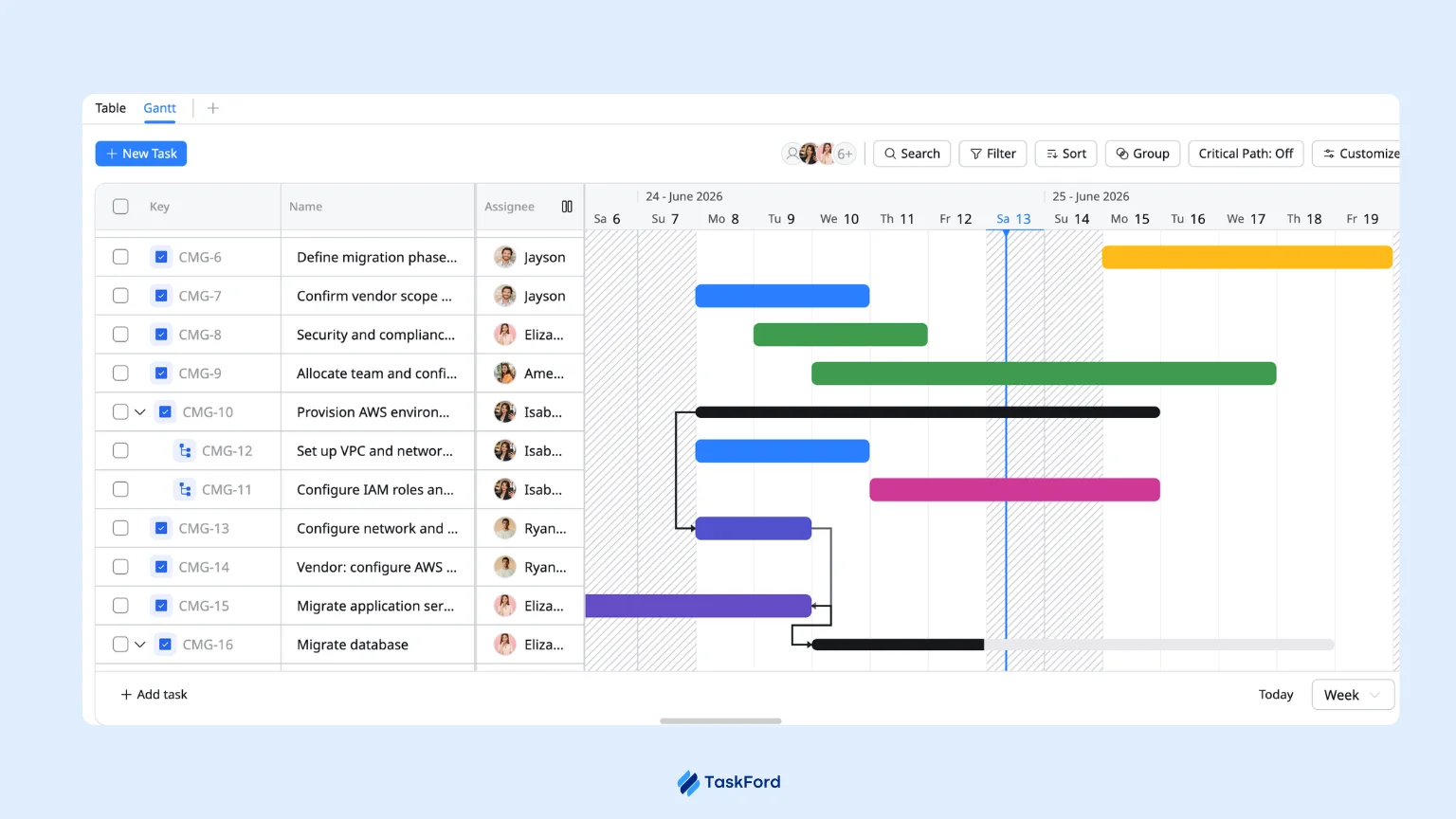

gantt view in it project delivery

  • Kanban view – answers “Where is work piling up?” If the Blocked column is filling, for example, the vendor AWS Direct Connect setup is delayed, you’ve found your bottleneck.

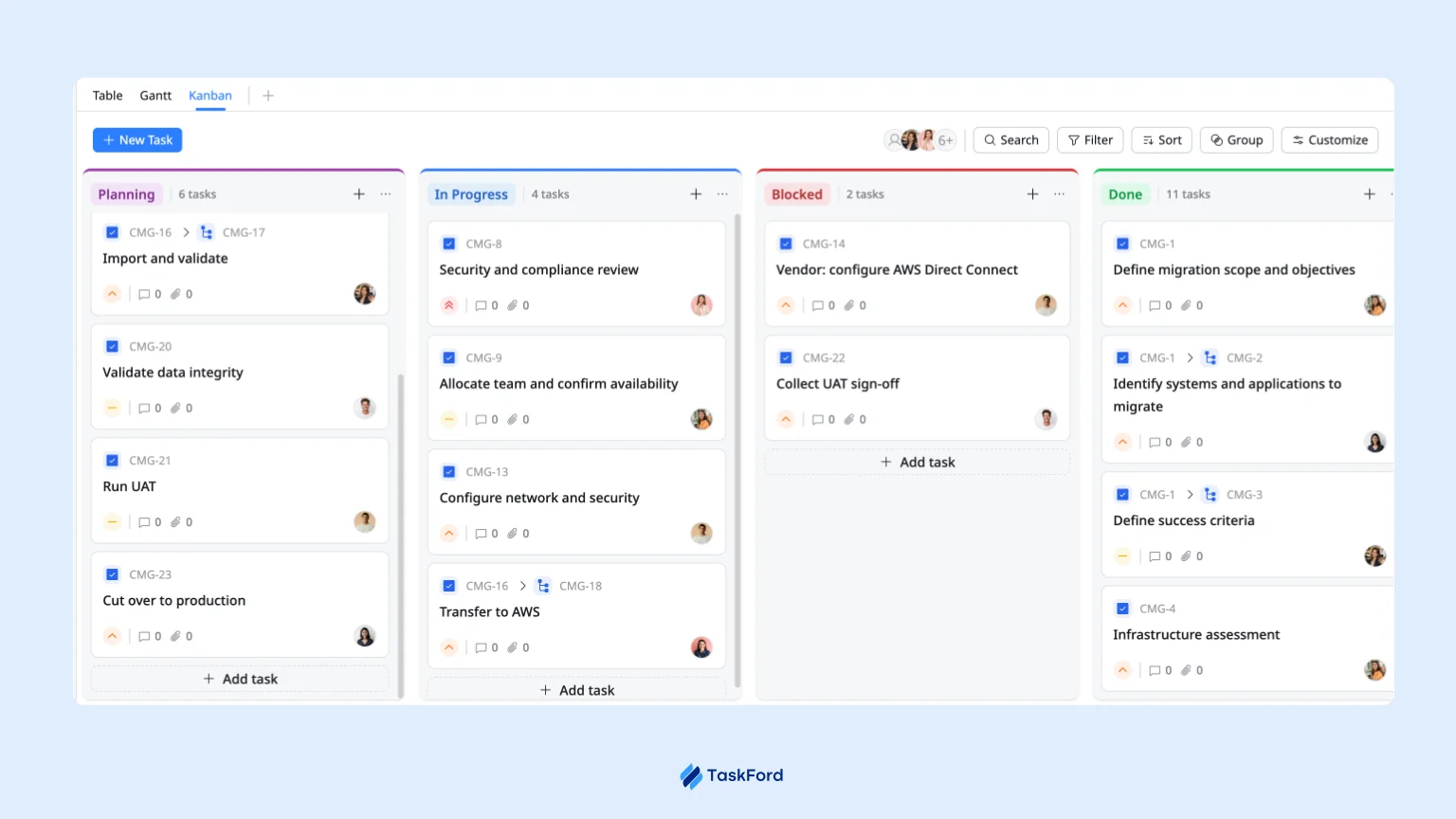

kanban in it project delivery

  • Table view – answers “What’s due this week?” Sort by Due Date or filter by Health to surface what needs immediate attention

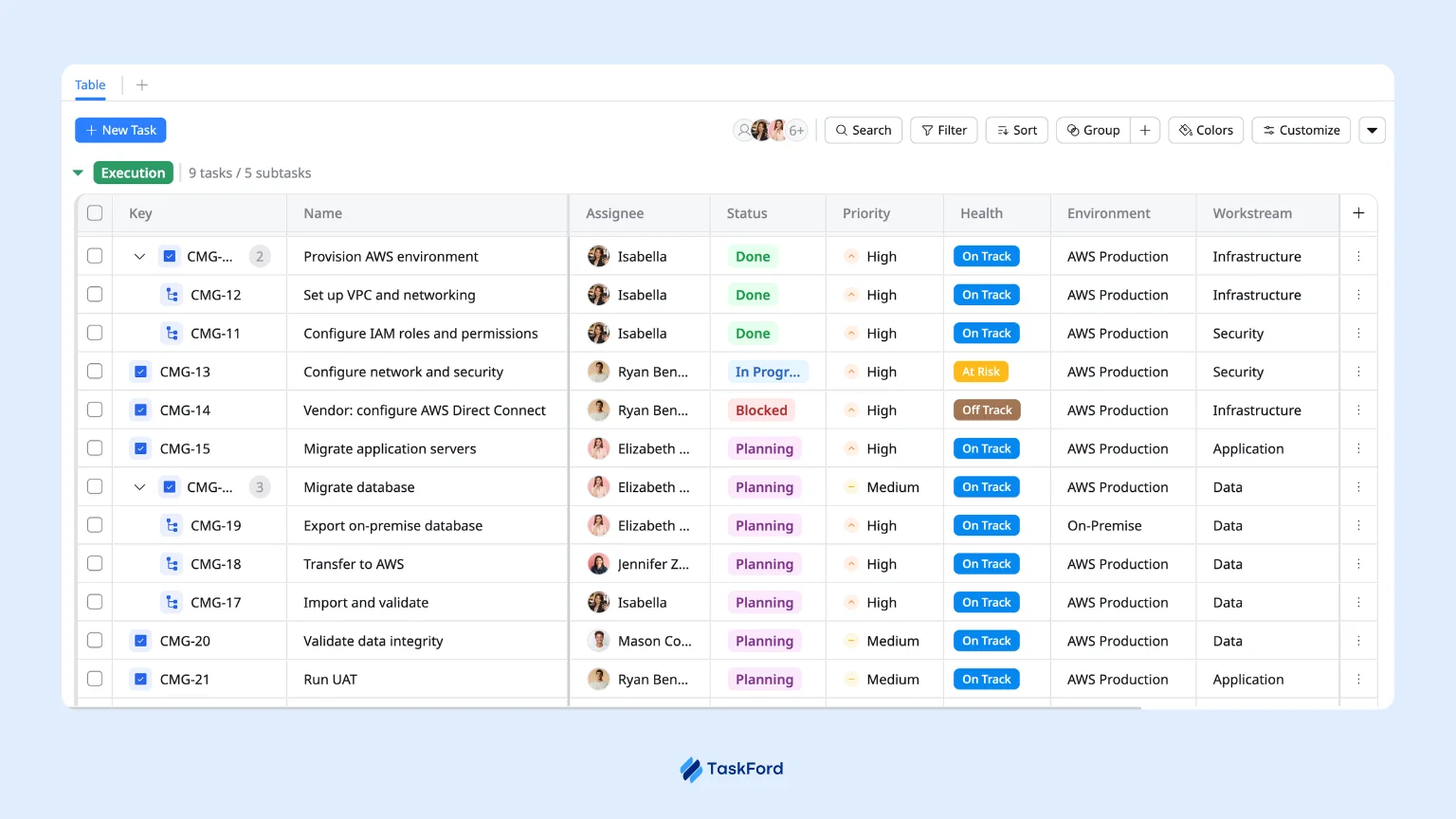

table view

Save the views you check every day:

Saved View Filter
Needs attention Status is Blocked or Due Date before today
This week Due Date within the next 7 days
At risk Health is At Risk or Off Track
By owner Group by Assignee

💡 Tip: Create a dedicated Risks & Issues section to track potential blockers such as vendor delays, security approvals, or migration failures. Assign an owner and review high-risk items regularly so problems are addressed before they impact key milestones.

Step 6 – Report project status without rebuilding status every week

Your IT Director and business stakeholders need to know if the migration is on track for cutover without being pulled into a status meeting every week.

Open the Overview tab in your project. Everything your stakeholders need to know is already there.

overview

  • Delivery Health shows overall project status at a glance: On Track, At Risk, or Off Track, along with completed and overdue task counts for the last 7 days.
  • What needs attention surfaces issues automatically: overdue tasks flagged with a count, and stale items that may need reassigning or archiving.
  • Workflow health shows task distribution across Planning, In Progress, Blocked, and Done. If Blocked is growing, you’ve found your bottleneck before a deadline slips.
  • Team workload shows active assignments per person. If one engineer is carrying significantly more than others, redistribute before it causes a delay.
  • Recent activity gives you a live feed of every status change and update across the project. Use it in standups instead of asking the team what changed.

💡 Tip: Share the Overview link with your IT Director before every steering meeting. They get the full picture without needing a separate status report.

Step 7 – Close the project properly

The migration is complete. Close the project the right way so nothing carries over and the next migration benefits from what you learned.

  1. Run a final task review, confirm every deliverable is marked Done before archiving
  2. Confirm all blocked tasks and open issues are resolved, nothing open should carry into operations
  3. Add delivery notes to each phase: what went well, what caused delays, what you’d change
  4. Compare actual hours and timeline against original estimates, if data migration took longer than planned, use that as your baseline next time
  5. Document the handover to operations: AWS environment owner, support contacts, runbooks, and any outstanding configuration items
  6. Archive the project so it stays searchable as a reference for future migrations

You’re ready to deliver

You now have everything you need to run IT project delivery in TaskFord from planning and coordination to progress tracking and stakeholder reporting, all in one place.

Ready to get started? Create your first IT project using the Project Management Templates and follow these steps with your team.
