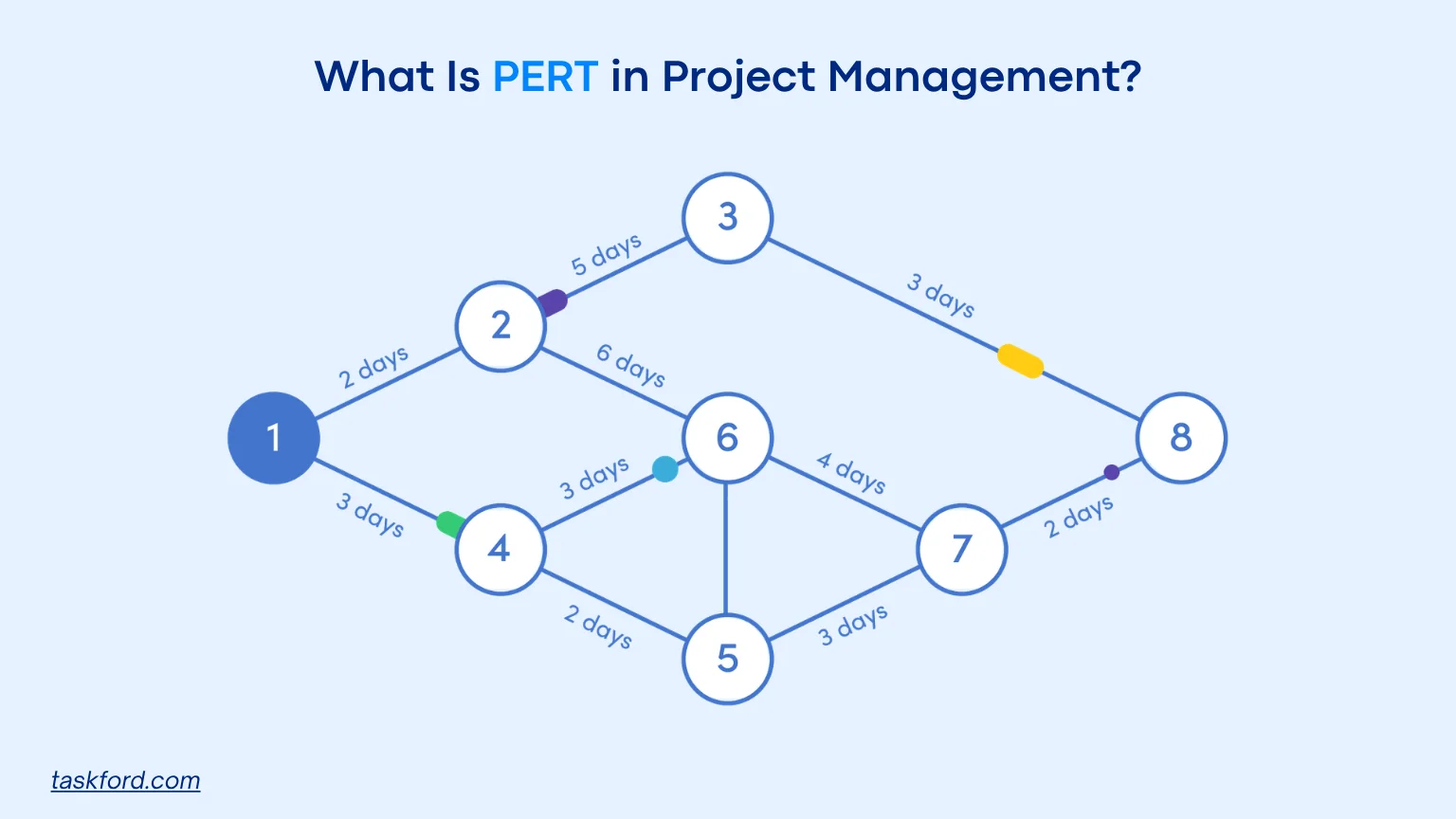

What Is PERT in Project Management?

PERT is a technique used to plan, schedule, and control projects with uncertain task durations. Developed for the U.S. Navy’s Polaris program, it helps map tasks, estimate timelines, and identify the critical path.

What Is PERT in Project Management?

Unlike other methods, PERT uses three time estimates for each task:

  • Optimistic Time (O): The shortest time a task could take under ideal conditions.
  • Most Likely Time (M): The most realistic estimate based on typical conditions.
  • Pessimistic Time (P): The longest time a task might take if things go wrong.

These estimates are combined using the formula TE = (O + 4M + P) / 6 to calculate the expected time (TE) for each task. This approach makes PERT ideal for projects with high variability, such as product development or infrastructure projects.

Why PERT Matters for Project Managers

Project managers often struggle with missed deadlines, unclear priorities, and resource bottlenecks, especially in complex or uncertain projects. PERT helps tackle these challenges in a more structured and proactive way:

  • More realistic time estimates: Instead of relying on a single guess, PERT uses three estimates to calculate a weighted average. This gives a more accurate timeline, especially for tasks where outcomes are unpredictable or depend on external factors.
  • Clear identification of the critical path: PERT maps out all tasks and their dependencies, making it easier to pinpoint the critical path. This allows project managers to prioritize high-impact activities and allocate resources where delays would matter most.
  • Better communication and alignment: By visualizing task sequences and dependencies in a network diagram, PERT provides a shared view of the project. Teams and stakeholders can clearly understand how work flows.
  • Stronger risk management plan: PERT highlights tasks with high uncertainty, helping managers identify potential delays early. This makes it easier to build contingency plans and reduce the chances of last-minute surprises.

Overall, PERT turns complex, uncertain projects into more predictable and manageable workflows by combining structured planning with flexibility.

How PERT Works in Project Management: A Step-by-Step Guide

Creating a PERT chart and applying it to project management involves clear, actionable steps. Below is a practical guide to get started.

Step 1: List All Tasks and Dependencies

Identify every task required to complete the project and determine which tasks depend on others (or dependencies​). For example, in a website development project, “design homepage” might depend on “finalize wireframes.”

Step 2: Estimate Time for Each Task

For each task, assign optimistic, most likely, and pessimistic time estimates. Suppose “design homepage” has:

  • Optimistic: 3 days
  • Most Likely: 5 days
  • Pessimistic: 8 days

Using the PERT formula:

TE = (3 + 4*5 + 8) / 6 = 31 / 6 ≈ 5.17 days

Step 3: Create the PERT Chart

Draw a PERT chart with:

  • Nodes: Represent milestones or events (e.g., “Project Start” or “Website Launch”).
  • Arrows: Represent tasks and their durations, connecting nodes to show dependencies.

For example, an arrow from “Finalize Wireframes” to “Design Homepage” shows that the latter cannot start until the former is complete.

Step 4: Identify the Critical Path

The critical path is the longest sequence of tasks determining the project’s minimum duration. Calculate the total time for each path through the chart and focus on the longest one. Any delay in critical path tasks will delay the entire project.

Step 5: Monitor and Update

As the project progresses, update the PERT chart with actual task durations. This keeps the schedule accurate and helps address delays early.

Example: In a software project, a PERT chart revealed that “user testing” was on the critical path. By allocating extra resources to this task, the team avoided a two-week delay.

Real-World Example: PERT in a Software Project

A mid-sized tech company was facing delays in launching a CRM system. To improve planning, they used PERT to estimate task durations, especially for testing and system integration.

For example, they calculated testing time using PERT: TE = (4 + 4×6 + 10) / 6 = 6.33 days. This gave them a more realistic estimate of how long testing would take.

Using PERT, they identified testing and bug fixing as the most critical tasks. Thanks to this information, the company reassigned more developers to focus on testing and bug fixing. This helped speed up the most important parts of the project.

As a result, the project timeline was reduced from 10 months to 8 months, making it 20% faster. It also improved communication and gave stakeholders a clearer understanding of the project timeline.

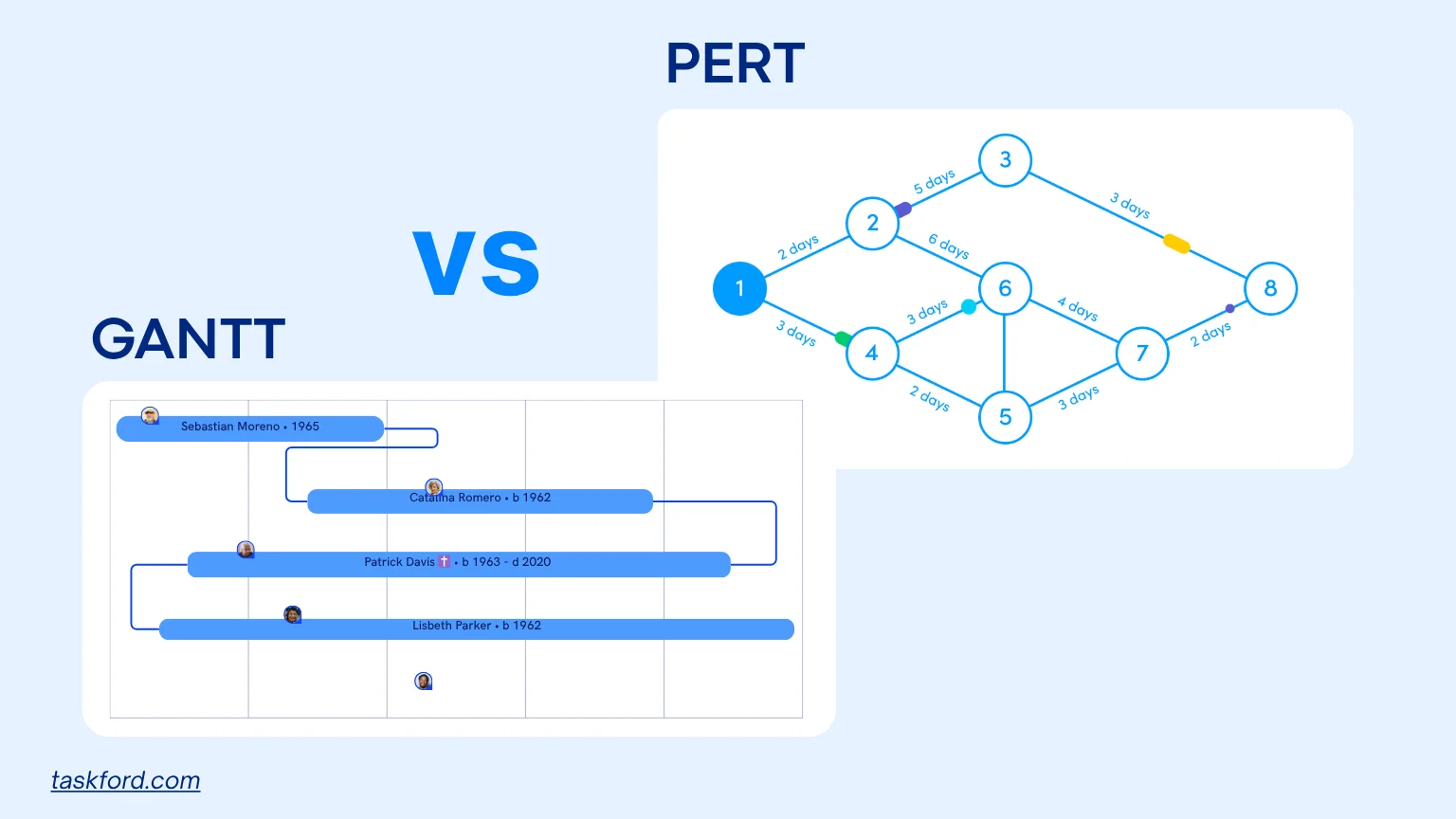

PERT vs. Gantt Charts: Key Differences

PERT vs. Gantt Charts:

While PERT is effective for planning complex projects, PERT Chart vs Gantt Chart comparisons often arise. Here’s how they differ:

Focus:

  • PERT emphasizes task dependencies and time uncertainty, using three-point estimates.
  • Gantt charts focus on task timelines and progress, showing start and end dates on a linear timeline.

Visualization:

  • PERT charts use nodes and arrows to map dependencies, making them ideal for complex workflows.
  • Gantt charts use horizontal bars to show task durations and overlaps, better for straightforward schedules.

Use Cases:

  • PERT suits projects with high uncertainty, like R&D or new product launches.
  • Gantt charts work well for projects with fixed timelines, like event planning or marketing campaigns.

When to Choose: Use PERT when tasks have variable durations or complex dependencies. Opt for Gantt charts for simpler projects where visualizing progress is key.

PERT vs. CPM: Which Is Right for Your Project?

Another common comparison is PERT vs. CPM in project management. The Critical Path Method (CPM) shares similarities with PERT but has distinct features.

Key Differences

Aspect PERT CPM
Focus Time estimation with uncertainty Time and cost optimization
Time Estimates Three estimates (O, M, P) Single, deterministic estimate
Use Cases R&D, software, innovative projects Construction, manufacturing projects
Complexity Handles uncertainty well Assumes predictable task durations

When to Use Each

  • PERT: Choose for projects with unpredictable tasks, like developing a new app where testing times vary.
  • CPM: Use for projects with known durations and costs, like building a bridge with fixed labor and material costs.

Example: A construction project manager used CPM to optimize costs for a highway project with clear timelines. Conversely, a biotech team used PERT for a drug trial, where testing phases had uncertain durations.

Challenges of Using PERT (and How to Overcome Them)

While powerful, PERT has challenges that project managers should address:

Challenge 1: Inaccurate Time Estimates

Problem: PERT relies on three time estimates (optimistic, most likely, and pessimistic). However, these estimates are often subjective and can be biased due to optimism, lack of experience, or external pressure. Without reliable data, the final expected duration may be misleading, which can derail project timelines.

Solution:

  • Use historical data from similar past projects to ground estimates in reality.
  • Break tasks into smaller, more manageable components to improve estimation accuracy.
  • Regularly review and update estimates as the project progresses

Challenge 2: Complexity in Large Projects

Problem: As project size increases, PERT charts can become highly complex, with numerous interdependent tasks. This can make the chart difficult to read, maintain, and communicate, especially for stakeholders unfamiliar with the method.

Solution:

  • Use project management software to automate chart creation and updates.
  • Divide the project into phases or sub-projects, each with its own simplified PERT diagram.
  • Focus on critical paths and key milestones rather than every minor task.
  • Use visual simplification techniques, such as grouping related activities or using color coding.
  • Regularly clean and update diagrams to reflect current project status.

Challenge 3: Resistance from Team Members

Problem: Team members may perceive PERT as overly technical or time-consuming, leading to resistance in adoption. This can result in incomplete data, poor collaboration, or inconsistent use of the method.

Solution:

  • Provide hands-on training with simple, real-world examples to build confidence.
  • Demonstrate the practical benefits, such as improved scheduling, risk identification, and workload clarity.
  • Integrate PERT into existing workflows and tools to reduce friction.
  • Encourage collaborative participation in building the PERT chart
  • Apply PERT to small projects before scaling up.

Frequently Asked Questions (FAQs)

1. What type of projects benefit most from PERT?

Projects with high uncertainty, complex dependencies, or many interrelated tasks—such as R&D, engineering, or large-scale transformations—benefit the most from PERT.

2. Is PERT suitable for small projects?

While it can be used for small projects, PERT is most valuable in larger, more complex initiatives where detailed planning and risk analysis are critical.

3. Does PERT require specialized tools?

Not necessarily. PERT diagrams can be created using basic tools like spreadsheets or diagram software, though dedicated project management tools can make the process easier.

4. How does PERT improve decision-making?

By providing a clearer picture of timelines, dependencies, and risks, PERT helps project managers make informed decisions about scheduling, resource allocation, and contingency planning.

5. Can PERT be combined with other methodologies?

Yes, PERT can be used alongside frameworks like Agile or Waterfall to enhance planning and time estimation, especially in the early stages of a project.

Conclusion: Take Control of Your Projects with PERT

PERT in project management is a powerful tool for tackling uncertainty, prioritizing tasks, and delivering projects on time. By using three-point estimates and mapping the critical path, PERT helps project managers navigate complex projects with confidence. Compared to Gantt charts and CPM, PERT excels in scenarios with unpredictable timelines, making it ideal for R&D, tech, or innovative projects. Start applying PERT today and explore more with our project management guide to streamline your workflow and reduce delays.
